Data quality
Duplicate learner records and inconsistent transcript fields reduced migration throughput.
Project recovery case study · Portfolio simulation
A simulated LMS migration reached Week 8 three weeks behind schedule, with testing delayed and the forecast moving beyond the approved budget. I developed a recovery plan that addressed schedule, budget, scope, resource constraints, and the leadership decisions required to protect the core launch date.
01 · Project overview
Northbridge Technologies was completing a fictional 16-week migration to a new learning management system. By the end of Week 8, content migration, data validation, testing, and launch readiness had fallen behind plan. The forecast had increased from $420,000 to $482,000, and the projected launch had moved from April 26 to May 17.
I approached the scenario as the project manager responsible for diagnosing the delivery problems, evaluating recovery options, resetting the critical path, and presenting leadership with a clear recommendation.
02 · Diagnosis
The project was not experiencing one isolated problem. Data quality, vendor responsiveness, SME capacity, scope growth, and decision latency were reinforcing one another across the critical path.
Duplicate learner records and inconsistent transcript fields reduced migration throughput.
Configuration issues remained unresolved beyond the agreed response window, delaying testing.
Business experts were balancing project responsibilities with ongoing operational work.
Advanced analytics and expanded single sign-on entered the launch scope after planning.
Cross-functional questions remained open because ownership and escalation deadlines were unclear.

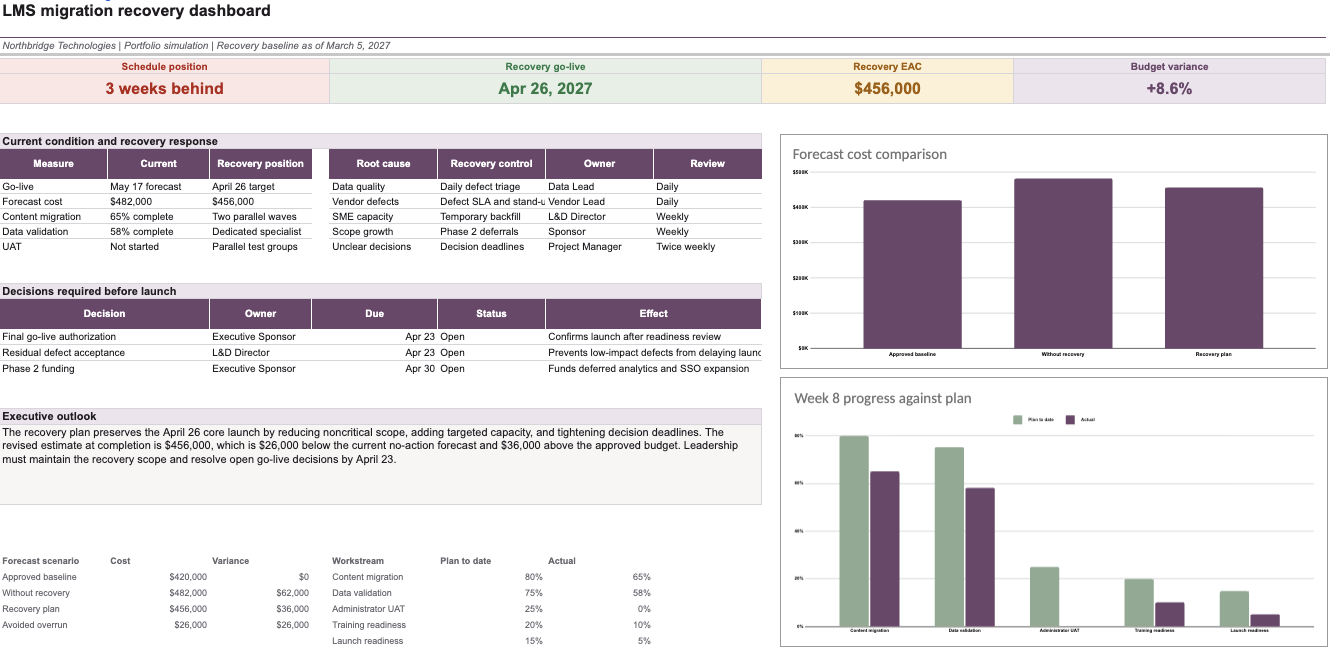

Week 8 status
03 · My approach

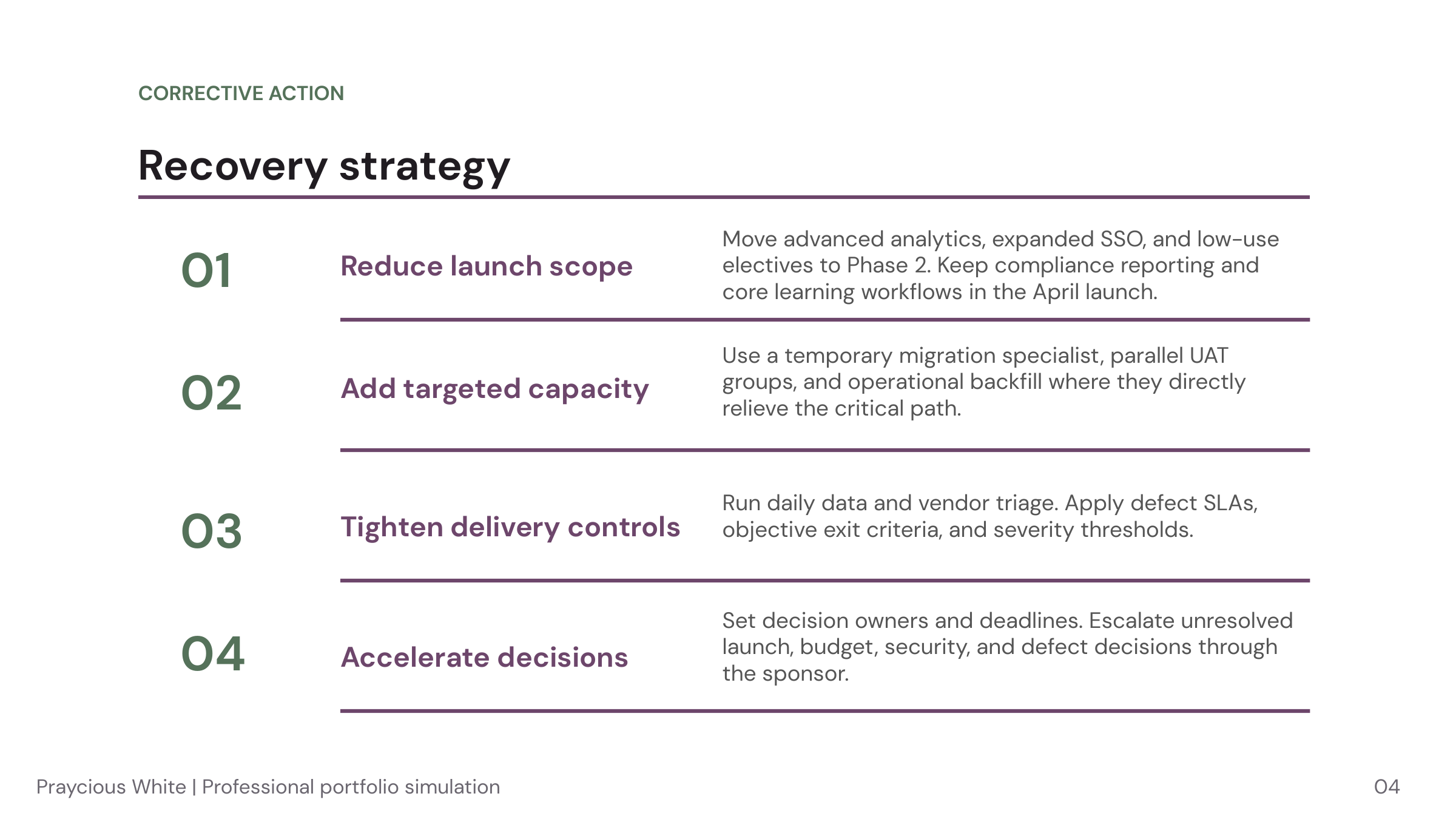

I evaluated the schedule, cost forecast, scope changes, dependencies, stakeholder responsibilities, and pending leadership decisions. The strategy added capacity only where it relieved the launch path and deferred work that did not protect core learning operations.
Move advanced analytics, expanded SSO, and lower-use electives to Phase 2 while preserving compliance reporting and core learning workflows.
Use a temporary data migration specialist, parallel UAT groups, and operational backfill where capacity directly relieves the critical path.
Introduce daily data and vendor triage, defect response expectations, objective test exit criteria, and defined severity thresholds.
Assign an owner and deadline to each launch, budget, security, and defect decision, then escalate unresolved items through the sponsor.

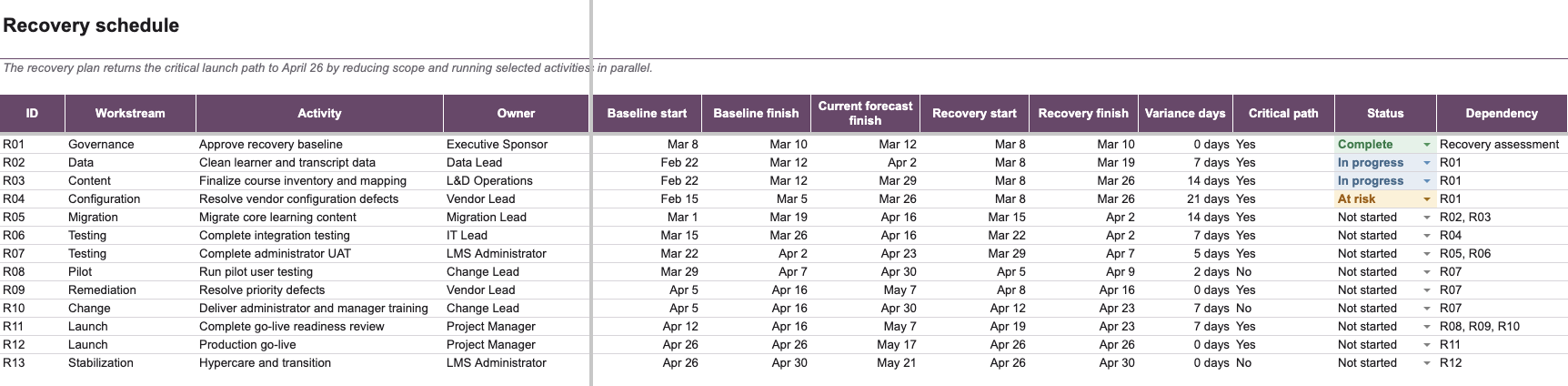

The recovery plan
The revised schedule overlaps selected workstreams while preserving the decisions and quality gates required for launch. Data cleansing, course mapping, configuration remediation, integration testing, and user acceptance testing become the primary critical-path activities.
04 · Scope and budget
The recommendation combines targeted investment with deliberate scope reduction. Additional spending is limited to resources that improve the critical path, while noncritical features move to a controlled second phase.

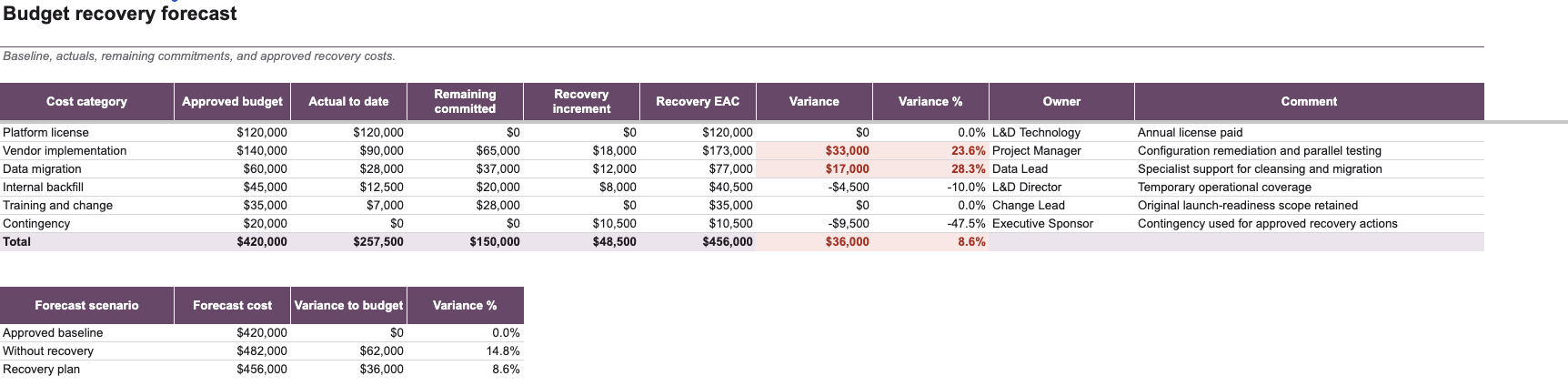

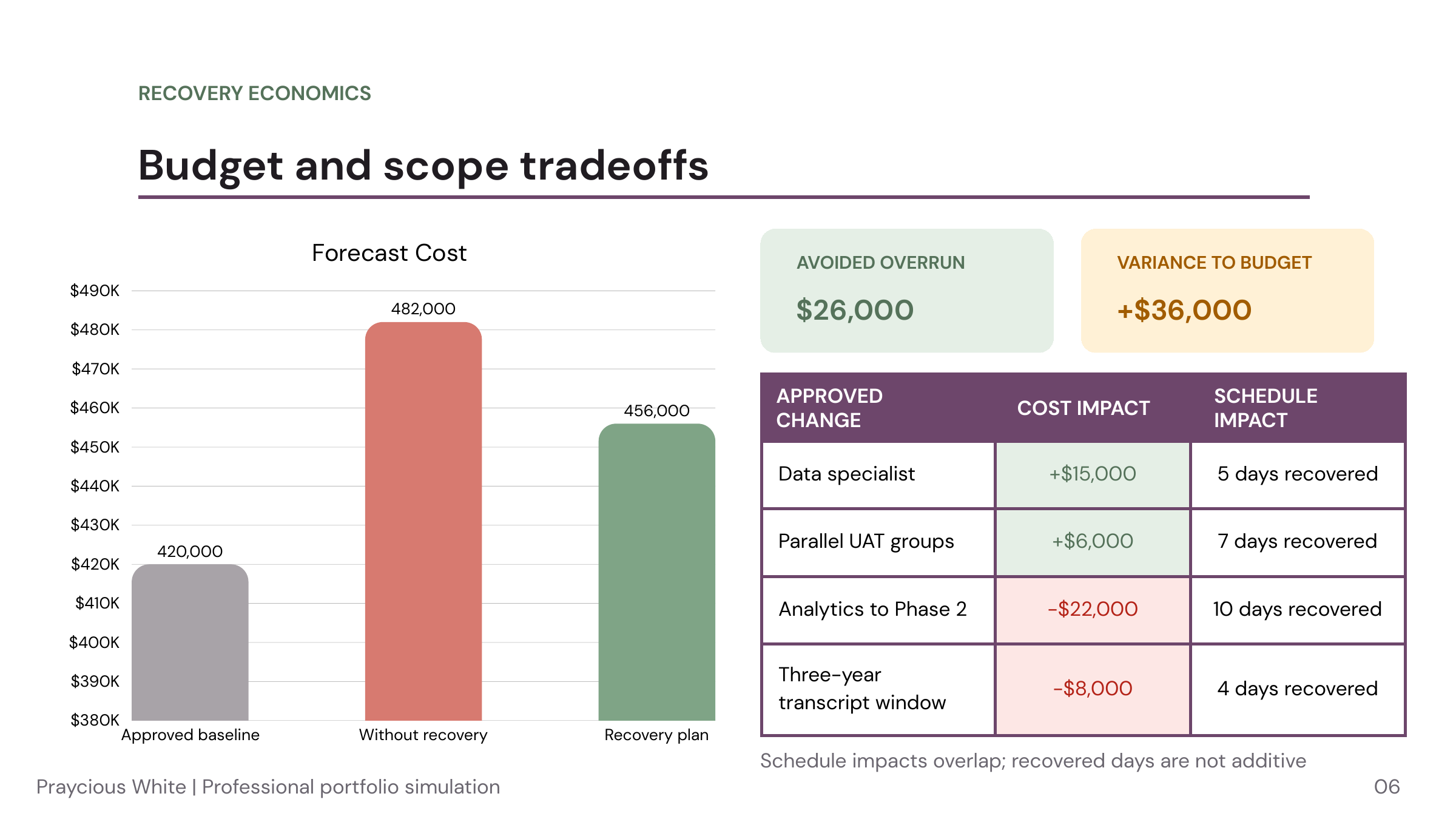

The recovery plan still requires a $36,000 increase over the original budget. The recommendation makes that tradeoff visible rather than presenting the recovered schedule as cost neutral.
| Decision | Cost impact | Schedule impact | Purpose |
|---|---|---|---|
| Data specialist | +$15,000 | 5 days recovered | Increase data cleansing throughput |
| Parallel UAT groups | +$6,000 | 7 days recovered | Test workstreams concurrently |
| Move analytics to Phase 2 | -$22,000 | 10 days recovered | Remove noncritical launch scope |
| Three-year transcript window | -$8,000 | 4 days recovered | Reduce initial migration volume |
Schedule impacts overlap; recovered days are not additive.
05 · Leadership governance
I created a decision log that assigns ownership and due dates to final go-live authorization, residual defect acceptance, Phase 2 funding, and other decisions affecting launch readiness.
Vendor defects and data quality.
Open decisions and operational readiness.

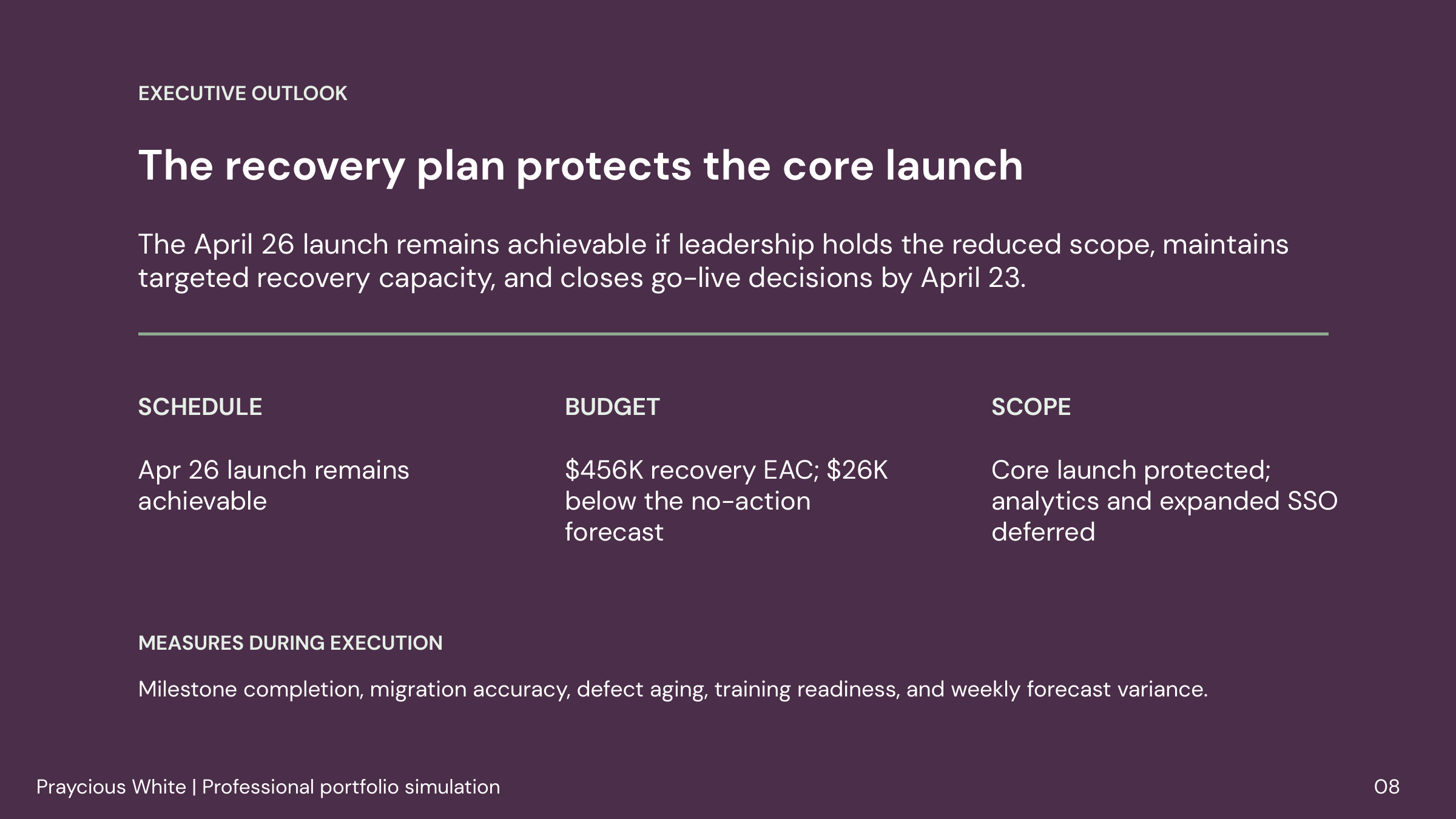

Forecast, risks, and launch readiness.
Escalate if the forecast exceeds $456,000, the launch date slips, a critical security defect remains open, or a readiness measure misses target.
06 · Project artifacts
The workbook proves the analysis and control logic. The executive brief shows how I translated that working model into a concise recommendation for leadership.
Summarizes the project baseline, root causes, recovery strategy, revised critical path, budget tradeoffs, and decisions required before launch.
Contains the executive dashboard, recovery schedule, budget forecast, change log, decision log, stakeholder plan, and project assumptions.
Skills demonstrated
This is a portfolio simulation. Dates, organization details, project data, and modeled recovery outcomes are fictional and are presented to demonstrate project management judgment, analysis, controls, and executive communication.
